Electric Fleet Charging Explained for Fleet Managers
- Jul 5
- 8 min read

TL;DR:
Electric fleet charging involves managing and scheduling vehicle recharging to ensure readiness while controlling costs. Proper infrastructure, utility coordination, and smart software are critical for optimizing vehicle availability and minimizing demand charges.
Electric fleet charging is the centralized process of managing and scheduling the charging of multiple electric vehicles at a depot to ensure every vehicle is ready for dispatch while controlling electricity costs and grid impact. Fleet managers use this process to replace ad hoc charging with a structured system built on infrastructure, software, and utility coordination. The industry standard term is “fleet depot charging,” and it operates under frameworks like NEC Article 625 for electrical safety and ISO 15118 for vehicle-to-charger communication. The critical performance metric is not how fast vehicles charge. It is the vehicle readiness rate: the percentage of vehicles charged to the required state before their scheduled departure.
What does a typical electric fleet charging setup involve?
A fleet EV charging setup combines physical infrastructure, electrical capacity, and software into one coordinated system. Getting that combination right from the start prevents costly redesigns later.

Charger types and when to use each
Two charger types dominate fleet depot design. Level 2 AC chargers deliver 7–22 kW and work well for vehicles with dwell times over 4 hours, such as overnight-parked delivery vans or company cars. Level 3 DC fast chargers deliver 50–350 kW and suit vehicles with short turnaround windows, like transit buses or logistics trucks on tight schedules. Choosing the wrong type is one of the most common and expensive mistakes in fleet EV charging setup.
The vehicle dwell time is the deciding factor. A delivery van parked for 10 hours overnight needs a Level 2 charger, not a DC fast charger. Installing DC fast chargers for long-dwell vehicles drives up both capital costs and monthly demand charges without adding operational value.

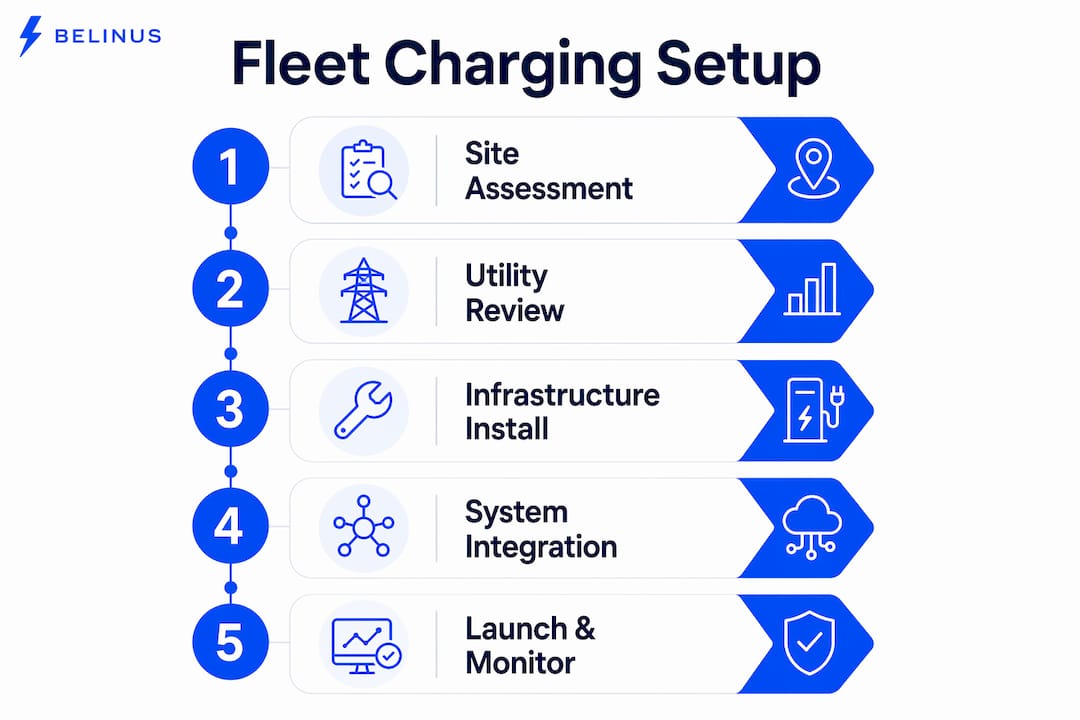

Setup timeline and costs
Setting up a commercial depot takes approximately 6–12 months, covering site assessment, permitting, electrical upgrades, and installation. That timeline is not a formality. Electrical permitting and utility interconnection alone can consume months of it.
A 10-bay Level 3 depot typically costs between $1 million and $2 million. Capital costs split across three categories:
Charging hardware: the charger units themselves
Electrical infrastructure: switchgear, transformers, and wiring
Civil works: trenching, conduit, and surface preparation
Modular charging designs can reduce total capital costs by 40–60% by cutting cabling and civil works. These designs support 6–20 bays per charger unit, which gives fleet managers room to expand without rebuilding the electrical backbone.
Pro Tip: Start your site assessment and utility capacity review before finalizing your charger count. Discovering a transformer upgrade is needed after you have ordered hardware adds months and significant cost to the project.

How does smart charging cut fleet electricity costs?
Smart charging is software-controlled load management that shifts vehicle charging to off-peak tariff windows and prevents all vehicles from drawing power simultaneously. Without it, a fleet of 20 vehicles plugging in at 6:00 PM creates a synchronized peak load that drives up demand charges for the entire month.
Smart charging management can reduce total charging costs by up to 40%, lower electricity demand charges by 30–50%, and increase charger utilization by 38% compared to unmanaged systems. Those are not marginal gains. For a mid-size fleet, a 40% reduction in charging costs can represent hundreds of thousands of dollars annually.
The core functions of a smart charging system include:
Load shifting: scheduling charging sessions during low-tariff overnight hours
Peak shaving: capping total depot power draw to stay below demand charge thresholds
Priority queuing: charging vehicles with the earliest dispatch time first
Real-time monitoring: tracking state of charge across all vehicles simultaneously
Fleet depots win economically by controlling charging times rather than competing for maximum speed. A smaller, well-managed power draw beats a large, unmanaged one every time on a monthly electricity bill.
Pro Tip: Pair your smart charging software with a battery storage system to absorb off-peak energy and discharge it during peak demand windows. This combination can eliminate demand charge exposure almost entirely.
What are the key utility coordination challenges?
Utility coordination is the most underestimated part of fleet charging infrastructure planning. Fleet managers who treat it as a final step rather than a first step routinely face delays that push launch dates back by a year or more.
Utility service upgrades take 6–18 months from application to completion. That lead time sits entirely outside the fleet manager’s control. Starting the utility engagement process early is not optional. It is the single most important scheduling decision in the entire project.
Utility coordination is the top risk factor in fleet charging deployments. Proactive engagement, early capacity assessments, and enrollment in specialized utility rate programs can significantly lower both project timelines and long-term operating costs.
The financial stakes of getting utility coordination wrong are high. Demand charges can cost $8–$22 per kW per month, and a single 15-minute peak draw sets the monthly charge regardless of total energy consumed. One unmanaged charging surge can inflate a monthly electricity bill by thousands of dollars.
Key actions for managing utility coordination effectively:
Request a capacity assessment early: confirm the existing service can support your projected load before designing the depot
Apply for interconnection immediately: utility queues move slowly, and late applications create the most common deployment delays
Ask about EV fleet rate riders: many utilities offer specialized rate programs for fleet operators that reduce demand charges significantly
Model both energy and demand charges: understanding both cost components prevents budget surprises after commissioning
Enrolling in specialized utility rate programs can significantly lower costs. These programs are available in most utility territories but require proactive enrollment, often before the depot goes live.
What operational strategies ensure high vehicle readiness?
Vehicle readiness rate is the correct KPI for fleet depot charging. Charger utilization measures how busy the hardware is. Vehicle readiness measures whether the fleet can actually operate. Those are different goals, and optimizing for the wrong one leads to poor decisions.
A practical framework for maximizing readiness involves four steps:
Map dispatch schedules first. Know exactly when each vehicle needs to depart and at what state of charge. Build the charging schedule backward from those constraints.
Match charger level to dwell time. Level 2 AC chargers suffice for dwell times over 4 hours and reduce both hardware costs and demand charges compared to DC fast charging. Reserve DC fast chargers for vehicles with short turnaround windows.
Deploy a dedicated Charging Management System. A Charging Management System (CMS) communicates via OCPP and handles depot-specific operations like charger scheduling, load management, and vehicle pre-conditioning. Existing Fleet Management Systems lack native support for these functions. The CMS and FMS work together but serve different roles.
Use pre-conditioning and schedule-aware charging. Pre-conditioning warms or cools the battery before departure, which improves range efficiency. Schedule-aware charging ensures the CMS knows each vehicle’s next dispatch time and prioritizes accordingly.
The Belinus ETAP Pro EV Charger integrates directly with fleet management workflows, giving fleet managers real-time visibility into charging status and schedule compliance from a single dashboard. Belinus’s centralized Energy Management System applies 15-minute dynamic tariff optimization across the entire depot, which keeps demand charges in check without manual intervention.
Integrating solar and storage with the depot charging system adds another layer of cost control. Solar generation during the day offsets daytime charging costs, and battery storage absorbs excess generation for use during evening charging peaks.
Pro Tip: Run a modular battery system alongside your depot chargers. Starting with a smaller battery and expanding as the fleet grows avoids overspecification and keeps initial capital costs manageable.
Key Takeaways
Successful electric fleet charging requires matching charger type to dwell time, engaging utilities early, and using a dedicated CMS to protect vehicle readiness and control demand charges.
Point | Details |
Vehicle readiness is the core KPI | Measure whether vehicles are charged for dispatch, not how busy chargers are. |
Match charger level to dwell time | Use Level 2 AC for sessions over 4 hours to cut hardware and demand charge costs. |
Start utility coordination first | Service upgrades take 6–18 months; late applications are the leading cause of delays. |
Smart charging cuts costs by up to 40% | Load shifting and peak shaving reduce demand charges and total electricity spend significantly. |
Modular designs reduce capital costs | Modular setups can lower total depot capital expenditure by 40–60% with room to expand. |
What fleet managers consistently get wrong about depot charging
The biggest mistake I see fleet managers make is treating depot charging like a scaled-up version of public charging. It is not. Public charging optimizes for speed because the driver is waiting. Depot charging optimizes for readiness and cost because the vehicles are parked anyway.
That reframe changes every decision. It means Level 2 chargers are often the right answer, not the cheap answer. It means the software layer matters more than the hardware spec. It means the utility relationship is a strategic asset, not a procurement checkbox.
The second mistake is underestimating how much demand charges shape the economics. Fleet managers who focus only on energy cost per kWh miss the fact that a single unmanaged peak can cost more in one month than weeks of optimized charging saves. The $8–$22 per kW demand charge range is not a footnote. It is often the largest line item on the electricity bill.
My practical recommendation: treat the CMS selection and the utility engagement as the two most important decisions in the project. The chargers themselves are almost a commodity. The software and the utility rate structure determine whether the depot is profitable or painful to operate.
— Marc
Belinus fleet charging solutions for your depot
Belinus builds energy systems designed specifically for the demands of commercial fleet operations. The ETAP Pro EV Charger integrates with fleet management workflows, and the Belinus EMS applies real-time tariff optimization across the entire depot to keep demand charges controlled without manual scheduling.

Belinus combines EV charging hardware, battery storage, and solar generation into one managed system. That integration means fleet managers get a single platform for smart charging management and energy cost control rather than three separate systems that need to communicate. For fleet operators ready to move from planning to deployment, the Belinus fleet charging solutions page covers the full range of commercial options and configuration support.
FAQ
What is fleet EV charging?
Fleet EV charging is the structured process of charging multiple electric vehicles at a central depot using scheduled, software-managed sessions to ensure vehicle readiness and control electricity costs.
How long does a fleet charging depot take to set up?
A commercial fleet depot takes approximately 6–12 months from site assessment to launch, with utility service upgrades often representing the longest lead-time item at 6–18 months.
What is the difference between Level 2 and Level 3 fleet chargers?
Level 2 AC chargers deliver 7–22 kW and suit vehicles with dwell times over 4 hours, while Level 3 DC fast chargers deliver 50–350 kW for vehicles with short turnaround windows.
Why are demand charges the biggest cost risk in fleet charging?
Demand charges of $8–$22 per kW per month are set by a single 15-minute peak draw, meaning one unmanaged charging surge can inflate the monthly electricity bill regardless of total energy consumed.
Do I need a separate Charging Management System if I already have fleet management software?
Yes. Existing Fleet Management Systems lack native support for charger scheduling, load management, and vehicle pre-conditioning. A dedicated CMS communicates via OCPP and handles these depot-specific functions alongside your existing FMS.
